Metric

What is task completion rate, and how do you measure it in Metabase?

Task completion rate is completed work divided by work due, committed, or planned in a period. Use it to understand whether teams finish the work they expected to finish, not to rank individuals.

TL;DR — Pick one denominator: due work, committed work, or planned work. Exclude archived, canceled, duplicate, and test items.

What does a task completion rate chart look like in Metabase?

Chart completed items over items due each week and read the level: the rise from about 71% to 84% means planning is getting more honest — teams are committing to amounts they actually finish. A one-week dip like May 18's usually marks an interrupt-heavy week, so check what unplanned work arrived before treating it as a planning failure.

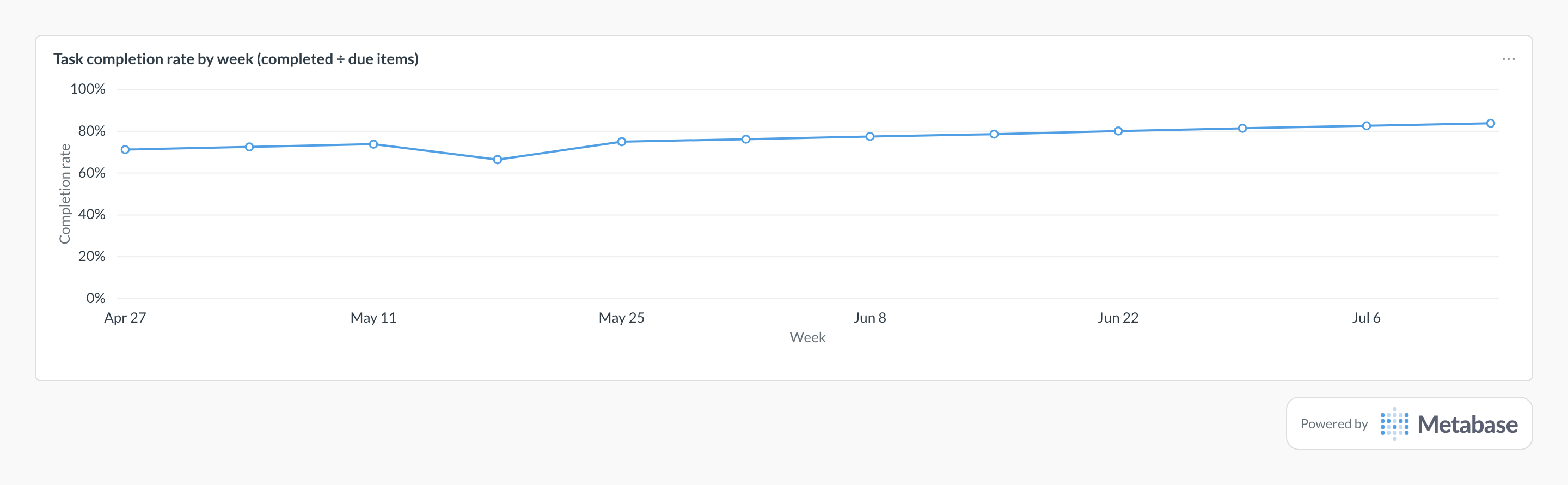

Task completion rate in Metabase: line chart of weekly completed-versus-due rate trending up.
Task completion rate as a Metabase card, built from synced work-management data. Figures are illustrative.

Definition

Task completion rate = completed items ÷ due or committed items. For weekly reporting, due-date based completion is the easiest cross-tool definition.

Data needed

  • completed_at or a done status
  • due_date or a committed/planned period
  • Archived/canceled flags to exclude non-work
  • Project, owner, team, and work type for segmentation

SQL pattern

Task completion rate by week PostgreSQL
SELECT
  date_trunc('week', due_date) AS week,
  COUNT(*) FILTER (WHERE completed_at IS NOT NULL) AS completed_items,
  COUNT(*) AS due_items,
  ROUND(
    100.0 * COUNT(*) FILTER (WHERE completed_at IS NOT NULL)
    / NULLIF(COUNT(*), 0),
    2
  ) AS task_completion_rate
FROM work_items
WHERE due_date IS NOT NULL
  AND archived_at IS NULL
  AND canceled_at IS NULL
GROUP BY 1
ORDER BY 1;

Pitfalls

Changing the denominator between dashboards. → Due work, committed work, and planned work answer different questions.
Ignoring missing due dates. → Track missing due dates separately or they silently disappear from due-date completion.
Using completion rate as an individual scoreboard. → Work size and interruption load vary; use it as a team planning metric.

FAQ

Should I use due date or sprint commitment?
Use due date for broad work-management tools and sprint/cycle commitment for agile delivery. Label the denominator so readers know what the rate means.
